LED Second Source Qualification: How to Add a Supplier Without Losing Optical Consistency
Quick Answer: What Second Source Qualification Has to Prove
Second source qualification has to prove interchangeability, not similarity. Two suppliers can both meet a datasheet and still deliver parts that look different side by side, so the qualification has to define which parameters are tight enough to guarantee a consistent result and which may vary without consequence.
The deliverable is not a certificate. It is a measured comparison, a mixed-lot validation result and a change rule that keeps the approval valid when either supplier modifies something.

Why an Alternate Supplier Changes the Product
Optical and electrical parameters are distributions, not fixed values. Each supplier controls its own process, its own binning rules and its own material supply, so the same nominal specification can arrive with a different centre point and a different spread.
Where consistency actually breaks
Difference shows up first in what the end user can see: dominant wavelength and colour appearance, intensity at the design drive current, and viewing angle. Difference that the user never sees still matters to the board, because forward voltage sets the usable drive window and the thermal path sets how far that window can be pushed before output moves.
None of this makes an alternate part unsuitable. It means qualification should test the parameters that carry visible and electrical risk, not the ones that are easiest to compare on paper.
What Has to Match Before an Alternate Is Usable
Treat the list below as the comparison set. Anything outside the window agreed against the first source is a reason to stop and re-scope, not a reason to negotiate after tooling.
| Parameter | Why it drifts between suppliers | What to compare |
|---|---|---|
| Dominant wavelength and bin code | Different bin definitions and different wafer supply | Measured value at the design current, not the bin label alone |
| Intensity and appearance | Different die, encapsulation and test condition | Reading through the production window at the production drive current |
| Forward voltage | Different process and material, wider spread at the limits | Full range across the lot against the driver window, not just the typical value |
| Viewing angle and beam shape | Different lens geometry and encapsulation | Off-axis response measured in the final enclosure |
| Package and footprint | Different mould and lead finish | Dimensions, polarity marking and coplanarity against the approved drawing |
| Thermal behaviour | Different die attach and lead frame | Output at the steady-state temperature the product actually reaches |
For programmes built around a standard numeric part, the same comparison runs at display level, which is why LED supplier quality work usually starts from the 7 segment LED display options already approved for the project rather than from a new datasheet.
Building the Cross-Qualification Plan
A cross-qualification plan is short and sequential. Write the acceptance window first, order samples second, and run the comparison third, because a comparison without a pre-agreed window becomes an argument about opinion.
- Freeze the reference: record the exact approved part, bin, drive condition and enclosure configuration the first source was validated in.
- Publish the acceptance window for each parameter on the comparison list, in measured units and at a stated test condition.
- Request measured data from the candidate, not a datasheet extract, and repeat the same measurements in house.
- Validate samples inside the production enclosure at the production drive current and the production ambient temperature.
- Run the mixed-lot trial described below before any purchase order for volume is released.
Step three is where OEM LED procurement teams usually save the most time later, because a supplier's own measurement at its own condition is evidence of capability rather than evidence of fit.

Cross-Mix Validation: The Step Most Projects Skip

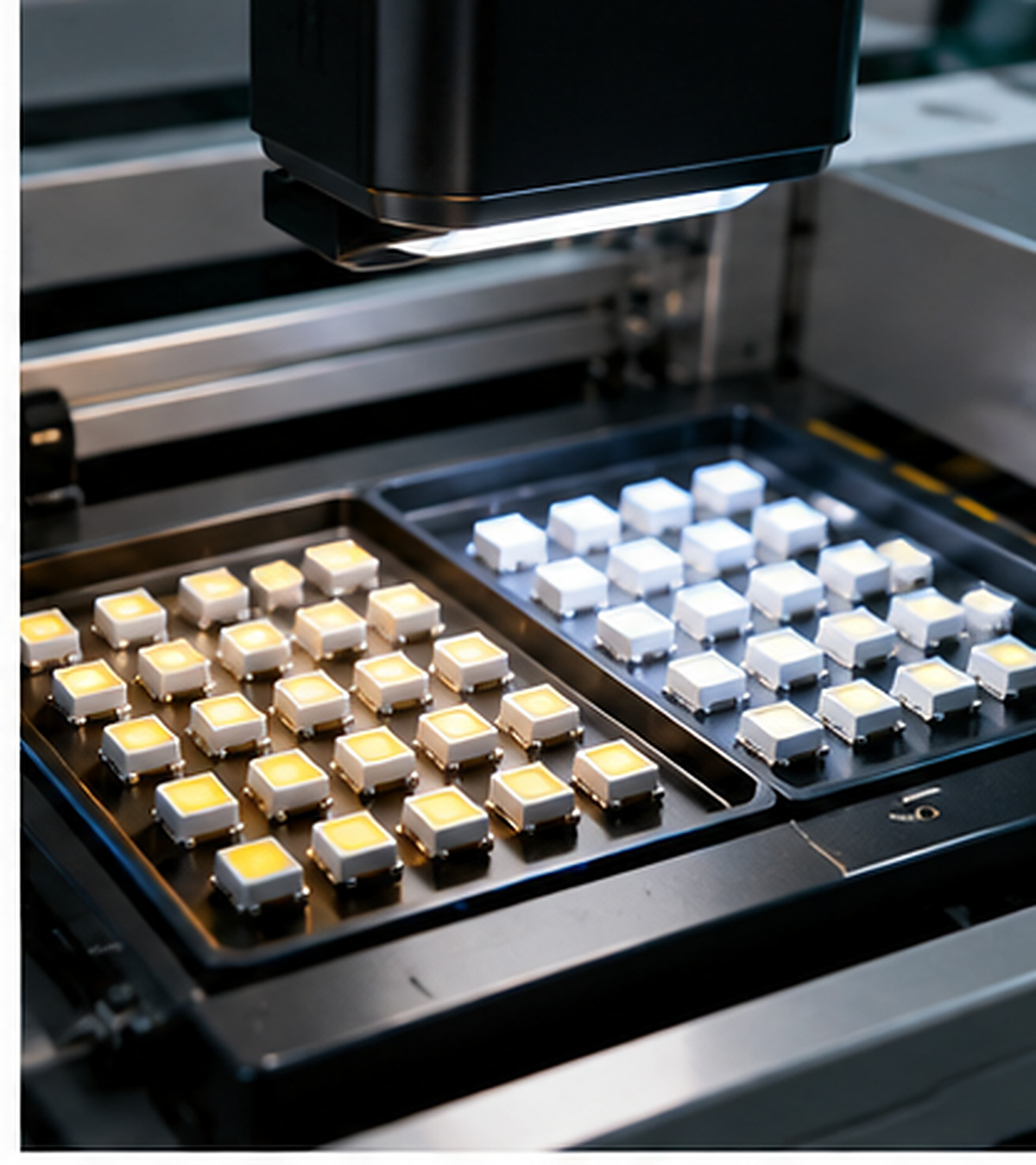

Passing alone is not the same as passing together. A candidate part that measures inside the window can still be visibly different from the approved part when both sit in one product, because the eye compares two units far more accurately than it compares one unit against a specification.
The mixed-lot trial answers that directly. Build a small number of units that contain both sources, ideally under the same front panel and in the same viewing geometry the customer will use, and compare them at low ambient light, at high ambient light and at the extremes of the viewing angle.
Two outcomes are possible and both are useful. If the mixed build is indistinguishable, the source can be approved for unrestricted use. If a difference is visible, the approval can still proceed but it has to be written as a restriction, for example a single-source-per-shipment rule or a single-source-per-product rule, and that restriction belongs in the purchasing record rather than in a conversation.
The trial also exposes the failure mode that paperwork misses: a candidate that shares the bin label but not the measured distribution. Because bin codes are defined by each supplier, comparing labels across two suppliers proves nothing, which is the same reason sample approval records the golden sample by measurement rather than by description.
What to Write Into the Approval Gate
An approval that is not written down expires quietly. The gate should state four things in the purchase record: the parameters and windows that were verified, the evidence reference for each measurement, the restricted-use case if the mixed-lot trial produced one, and the events that invalidate the approval.
Those events are the standard change triggers. A die or wafer change, a material or supplier change at the second tier, a mould or lead-frame change, an encapsulation change or a test-condition change all re-open the qualification, and the mechanism for notifying them is the same supplier change notification process used for a single-source part.
Where the programme already has a supplier quality agreement in place, second source terms belong inside it rather than in a separate document, so that one contract covers both sources. Where the programme is building the evidence trail for the first time, a first article inspection report for the candidate gives the dimensional and measurement baseline the approval gate needs.
Finally, treat the approved pair as one configuration. A dual-source programme that is managed as two independent parts will drift, because nobody owns the comparison after the paperwork is filed. Assign the comparison to the same owner who owns the specification, and re-run it whenever either source changes.
Frequently Asked Questions
What should OEM buyers require for LED second source qualification?
Require a measured comparison against the approved first source covering colour, intensity, forward voltage, viewing angle and footprint. Require the comparison to be taken at the production drive current and inside the production enclosure.
Which documents or evidence matter for LED second source qualification?
The useful evidence is measurement based: test data at the production condition, dimensional reports against the approved drawing and a process flow for the affected manufacturing steps. A certificate alone does not demonstrate that two sources will behave the same way in the product.
How should a supplier and buyer define acceptance for LED second source qualification?
Acceptance should be a written window for every parameter the end user can perceive, agreed before samples are ordered. Everything else is recorded as monitored variation with a named action limit.
What should be checked before approving LED second source qualification?
Check the mixed-lot result first, because a candidate that passes alone can still fail when units from both sources ship in one product. Then check that the change rule names who must be notified and which events re-open the approval.
Can a second source be approved without new sample validation?
No, because sample validation is the only step that places both sources side by side in the real enclosure. Where the candidate is electrically compatible but optically different, the approval has to be restricted to the products where that difference cannot be seen.

Conclusion: Approving an Alternate Without Creating a Second Product
LED second source qualification comes down to one idea: the comparison has to be measured, agreed and tested together, not inferred from two datasheets. Fix the acceptance window before samples arrive, compare the parameters the customer can see as well as the ones the driver cares about, and run the mixed-lot trial that turns an opinion into evidence.
Doing that work once creates a reusable gate. The next candidate then enters the same sequence with the same windows, which is what turns Supply Continuity & Lifecycle from a slide in a review into a control that holds, and it raises the quality of every later OEM LED procurement decision because the reference point is documented rather than remembered.
If you are planning a dual-source programme and want the comparison windows set before you approach a second supplier, send the specification and drive conditions to our engineering team through the inquiry page.
